Night and Weekend Paving: Keeping Your Lot Open

Published

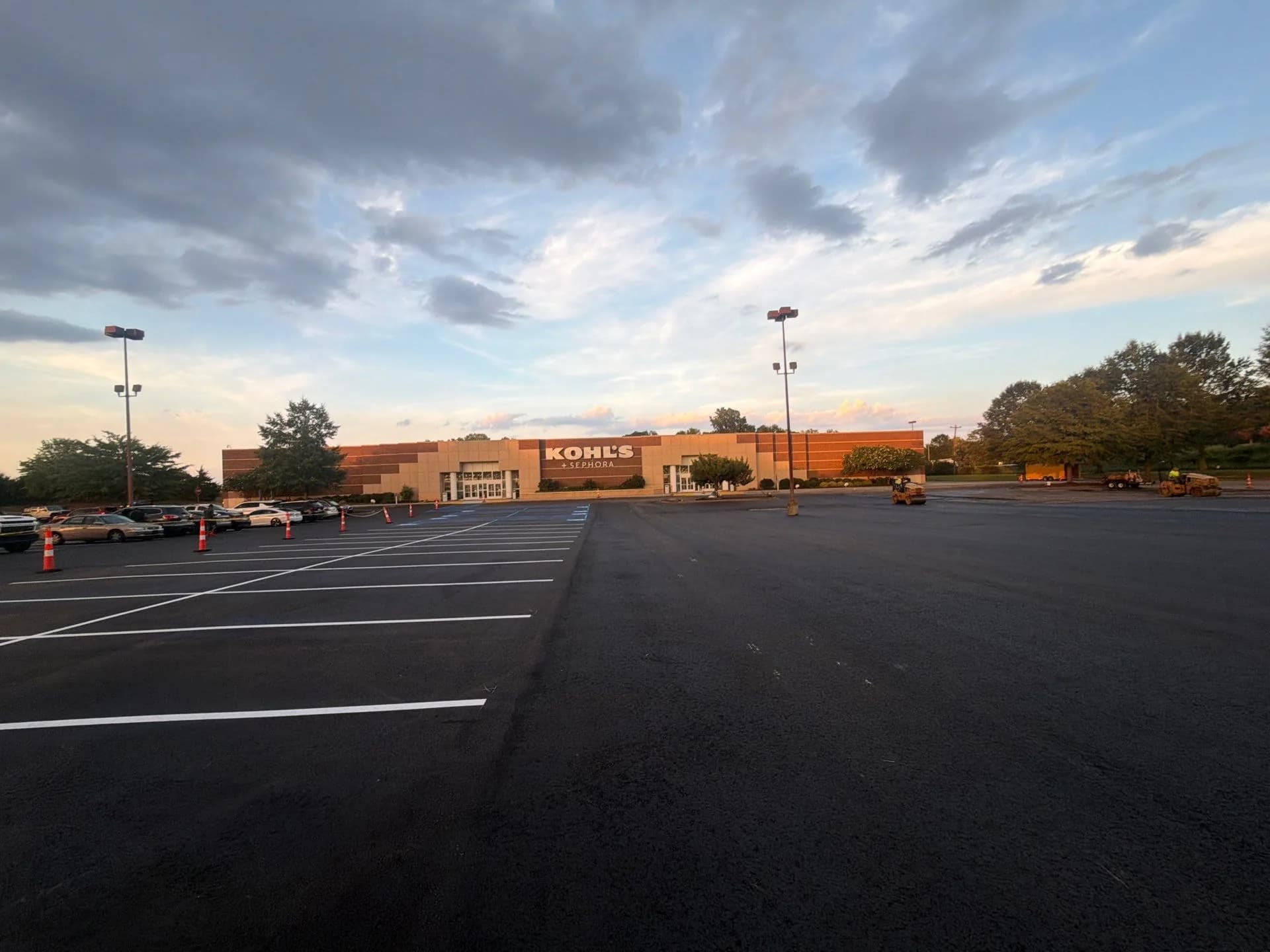

A big box retail parking lot at dusk with freshly paved asphalt and new white stall lines, cones separating the finished section from cars still parked near the store entrance

The most common reason a property owner puts off paving is not the price. It is the fear that the work will cost them a week of business. That fear is reasonable and, on most commercial sites, avoidable. Nearly every retail lot, distribution yard and medical campus we have paved stayed open the entire time.

Phasing Is the Whole Job

A parking lot is not one surface. It is a set of zones that matter at different times of day: the entrance drive, the front rows customers actually use, the far rows that fill only on a Saturday, the truck court, the dumpster pad, the fire lane.

Phasing means sequencing those zones so that the ones your operation depends on are always available. In practice that looks like:

  • Paving the far half of the lot first, with the near half open and coned off, then reversing it once the first half is open to traffic.
  • Taking a truck court on a Sunday when no deliveries are scheduled, rather than fighting trailers all week.
  • Splitting a single long drive aisle lengthwise so one lane carries traffic while the other is milled and paved.
  • Doing the dumpster pad and the loading dock apron on the same night the store is closed, so waste and delivery service never lapse.

The plan is drawn before anybody mobilizes, and it is drawn around your calendar. A grocery store's worst day is not a distribution center's worst day.

When Night Work Is the Right Answer

Night paving is not automatically better, it is a tool with real trade offs. It is the right call when the site simply has no low-traffic window during the day: a busy shopping center on a main road, a hospital campus, a facility that runs shifts around the clock, or a road tie-in where a lane closure would back traffic onto a state route.

What it buys you is an empty lot with no vehicles to work around, no customers walking through the work zone, and a finished section open before the doors open.

What it costs is a slower and more careful operation. Asphalt has to be placed at temperature, and cool overnight air narrows the window between the truck and the roller. Lighting has to be brought in and set so the crew can actually see the mat, joints and edges. Compaction has to be right the first time, because there is no going back over a cooled mat. A crew that paves at night regularly does this well. A crew that does it occasionally does not.

What You Should Expect From the Contractor

The paving is the straightforward part. Keeping a site operating around it is where the job is won or lost, and it is worth asking directly how a contractor handles each of these:

  • A written phase plan with dates, zones and the number of spaces out of service in each phase.
  • Traffic control and pedestrian routing that is actually laid out, not a handful of cones dropped that morning. Accessible spaces and the accessible route to the entrance must remain available in every phase, which is a legal obligation and not a courtesy.
  • Signage and advance notice so customers, tenants and delivery drivers know what is happening before they arrive to find their usual row closed.
  • Realistic cure and open times. New asphalt takes traffic quickly but is not instantly at full strength, and seal coating has its own drying window. A contractor who tells you a lot will be open sooner than it will is going to make that your problem later.
  • A single point of contact who is on site and answers the phone when your store manager calls at ten at night.

Weather Is the Variable Nobody Controls

The one honest caveat: a phase plan is a plan, and asphalt cannot be placed on a wet surface or into standing water. Carolinas summers produce afternoon storms that arrive in twenty minutes and shut a paving operation down. Good phasing accounts for this by never leaving a zone in an unusable state overnight, so a rained-out shift costs a day of schedule rather than a day of your operation.

Ask Before You Assume It Cannot Be Done

Plenty of properties defer needed work for years on the assumption that fixing the lot means closing the site. In most cases it does not. If you have been putting off resurfacing or a full replacement because you could not imagine the disruption, tell us how your property runs and let us draw the phase plan first. The schedule is usually the easy part of the conversation.
