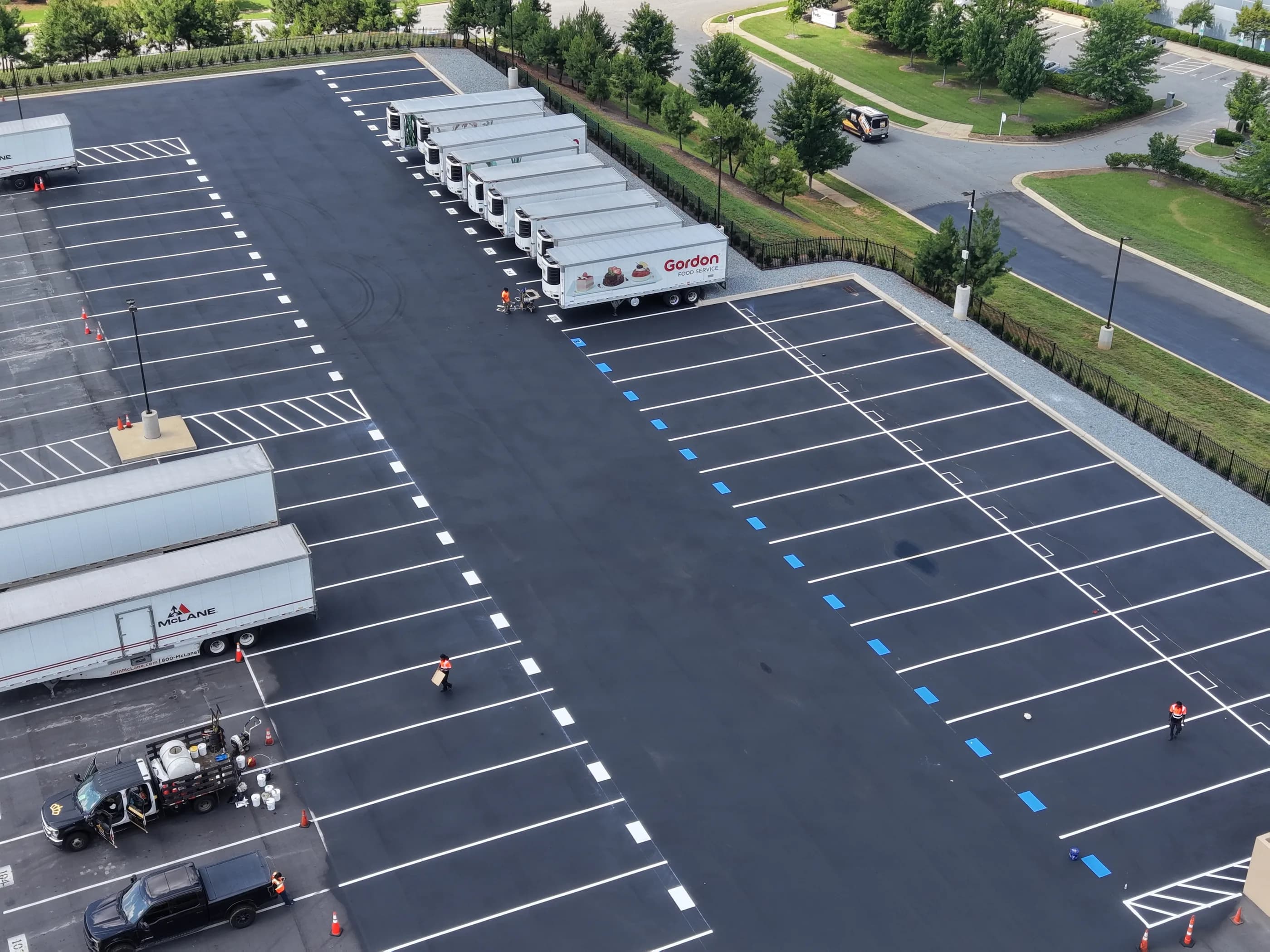

An aerial view of a freshly striped distribution center yard, with white stalls, blue accessible spaces, hatched loading zones and refrigerated trailers backed into the docks

Most commercial parking lots need restriping every 18 to 24 months. That is the honest average across the retail centers, distribution yards and industrial sites we maintain across the Carolinas, and it is a starting point rather than a rule. Two lots paved the same week, striped with the same material, can be a year apart in how fast the lines go. What separates them is traffic, sun, surface and the standard the property is held to.

What Actually Wears the Lines Off

Paint does not fade evenly. It fails where the work happens.

  • Traffic volume and turnover. A grocery lot where every space fills and empties a dozen times a day wears its stalls far faster than an office lot where cars park once at eight and leave at five. Drive lanes and the aisles nearest the door always go first.
  • Sun exposure. Ultraviolet light breaks down the binder in the paint. South-facing rows and open lots with no tree line fade visibly sooner than shaded edges of the same property.
  • Snow removal and power sweeping. A plow blade or a hard-bristle sweeper takes striping off in a single season. Lots that get aggressive winter service need a shorter cycle, and that is a scheduling fact rather than a complaint about the contractor.
  • Surface condition. Paint applied over oxidized, porous asphalt soaks in and dulls quickly. On a freshly sealed or newly paved surface, the same material sits up and holds its brightness far longer.
  • Material choice. Water-based traffic paint is the standard for a reason: it is fast, low odour and repaintable. Thermoplastic and epoxy cost more up front and last several times longer, which is why they earn their place on fire lanes, crosswalks and drive aisles that carry truck traffic.

The Cycle by Property Type

These are the intervals we plan around when we build a maintenance schedule. Your lot may sit on either side of them.

  • Retail and grocery centers: 12 to 18 months. High turnover, high visibility, and the lot is the first thing a customer sees.
  • Distribution and industrial yards: 12 to 24 months, with trailer stalls and truck courts on the shorter end because of tire scrub in the turns.
  • Office and medical parks: 24 to 36 months. Lower turnover, but accessible routes and fire lanes still need to read clearly at all times.
  • Churches, schools and community facilities: 24 to 36 months, driven more by seasonal peaks and safety markings than by daily wear.

The Part That Is Not Optional

Faded stalls are a cosmetic problem. Faded accessible parking is a legal one.

ADA requirements do not lapse because paint wore off. Accessible spaces, access aisles, the required signage and the route to the entrance all have to be identifiable, and a striping layout that has faded to the point of ambiguity is a real exposure for the property owner. Fire lanes carry the same weight under local fire code. When we walk a lot, those markings get assessed first and separately from everything else, because they are the ones that carry consequences beyond appearance.

Restriping in the Same Layout, or Changing It

A repaint over the existing layout is the fast, inexpensive option and it is the right one most of the time. But a restripe is also the cheapest moment you will ever have to change how the lot works. Adding accessible spaces, widening a drive aisle, creating order pickup stalls, converting dead corners into trailer parking or EV bays, or restriping to a tighter module for more capacity: all of it costs a fraction during a scheduled restripe compared with a standalone project later.

If your lot layout has not been questioned in a decade and the way people use the property has changed, say so before the crew mobilizes rather than after.

Time It With the Rest of the Work

Striping is the last operation on almost every job, and that makes it the natural anchor for a maintenance calendar. Do not repaint a lot in March that is scheduled for resurfacing in September. Do not seal coat a freshly striped surface. The correct order is repair, then seal, then stripe, and getting it wrong means paying twice for the same lines.

If you are not sure where your property sits in that cycle, ask us to walk it. A striping assessment takes an afternoon, and it usually surfaces two or three things worth handling in the same mobilization.
